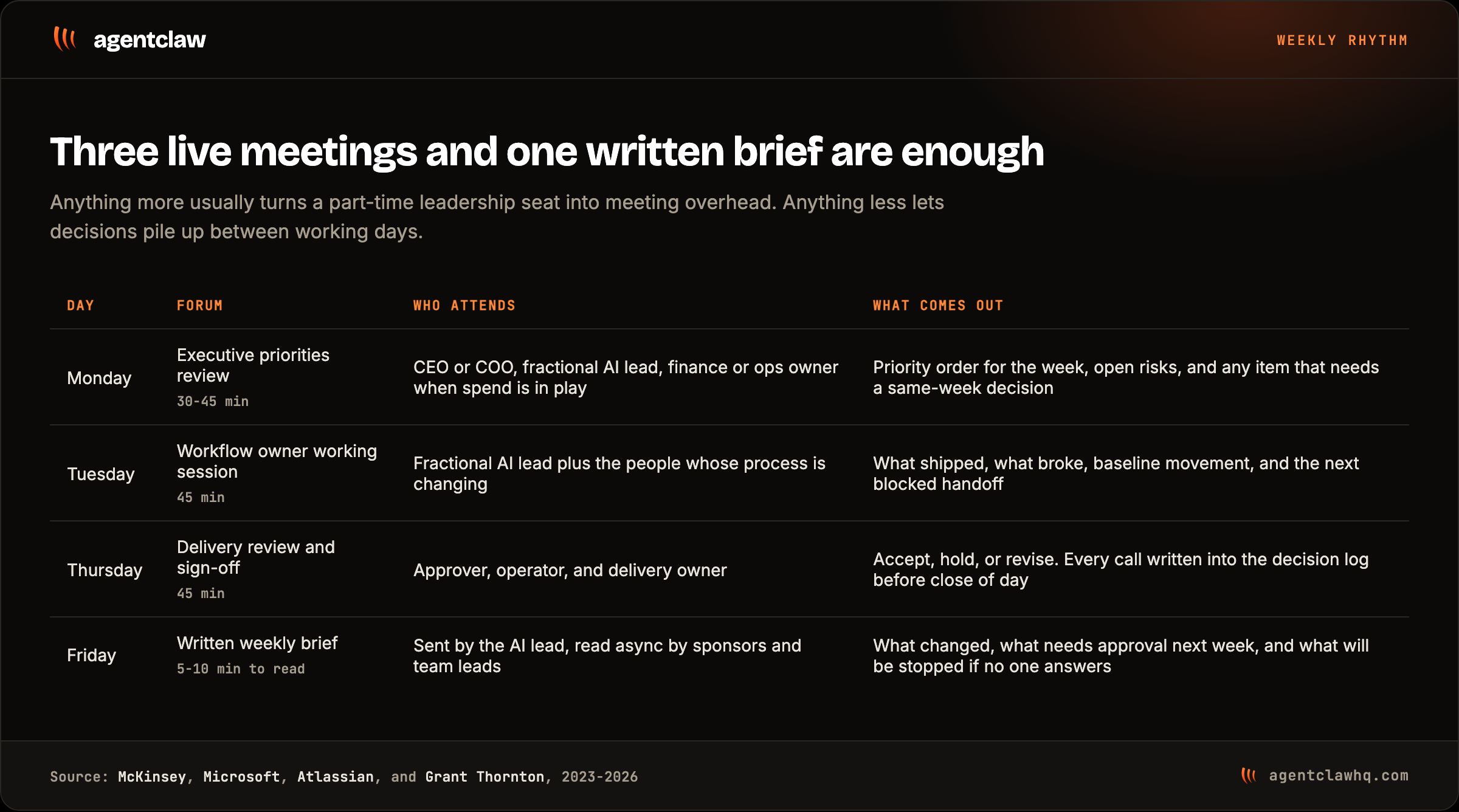

The Monday executive review is the only meeting that should move priorities. If a department head tries to reshuffle the list later in the week without coming back through the named approver, the list is not ranked. It is political.
The fractional AI lead is the driver for that Monday review. The approver is usually the CEO in a smaller company or the COO in a company where AI is touching operations more than product. Finance joins only when spend or vendor terms are live. The output is not a conversation summary. It is the ranked list for the week.
Tuesday belongs closer to the operator. This is where the warehouse lead, controller, claims manager, recruiter, or support lead says what actually happened when the workflow met real work. The fractional lead drives. The workflow owner brings evidence. If you are buying an outside seat that never sits with the people doing the work, you are buying an interpreter, not an owner.

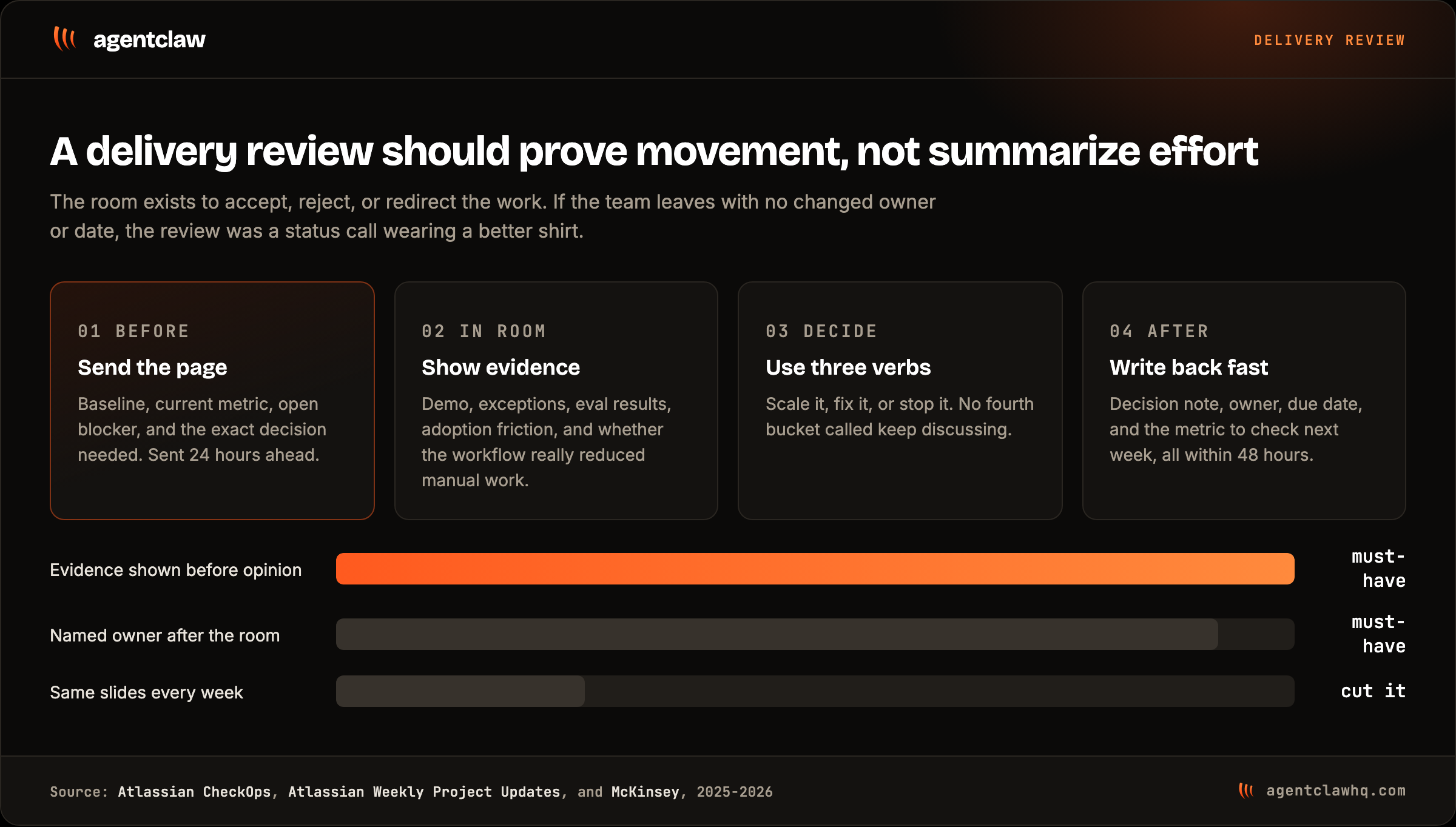

Thursday is the acceptance surface. It should answer one question: does the work move forward as built, move forward with fixes, or stop? If the answer is some softer version of keep discussing, the meeting is not a review. It is a stall.
Friday should not be another meeting. Atlassian's weekly project update play says weekly project updates should be shared once a week at the end of the week, and that teams documenting key information are 4.6 times more likely to meet deadlines. That maps cleanly here. The sponsor needs one page they can scan in five minutes, not another half hour on the calendar.
If the company has not ranked the queue yet, this is where a lighter assessment can help. Our 10x audit exists to sort the backlog before anyone commits to a longer operating seat.
